Project Risk Coordinator Career Path: Courses and Portfolio Project

Build a project risk coordinator portfolio with course resources, five practical stages, exercises and a project review rubric.

Project Risk Coordinator Career Path — 3 course resources, five stages and one portfolio project; red frame and WikiFree.com branding

Career studio / Risk Management

Build evidence for the Project Risk Coordinator role

A weekend learning event depends on a venue, a trainer and a registration system. Build a living risk register that connects early warning signs to decisions.

Beginner3 course resources5 practical stages1 portfolio project

Your outcome: Risk register, response plan and escalation briefing.

Start with the right expectations

Who this is for

Basic project concepts; understand that a risk is uncertain and an issue has already occurred.

This path develops a demonstrable work sample for the named role. It does not replace employer-specific experience, professional qualifications or supervised practice.

Plan your study time

Use a flexible six-week project schedule: one week for each of the first four stages and two weeks for the portfolio and review. Allow roughly 3–5 hours per week for the case work, in addition to course study. This is a planning suggestion, not a measured course duration or a promise of job readiness.

Read the course access notes before starting. Free viewing or reading does not automatically include certificates, graded assessments, software licences or paid cloud resources. Core case work can be documented with a free editor and spreadsheet; optional implementation tools may have additional requirements.

Your course sequence

Start in the order below. Use the course outline to select the sections relevant to the stage tasks, and complete foundation exercises before moving on. Full provider courses can be substantially longer than this project schedule. These are course resources, not a claimed count of individual lessons.

Resource 02 / Simplilearn

Free Simplilearn Course: Project Risk Management and Risk Analysis

Purpose: Develop the role-specific method. Connect your notes to the case tasks below rather than only collecting completion marks.

  • Explore risk frameworks, qualitative and quantitative analysis, probability-impact matrices and expected monetary value.
  • Follow the selected explanations of Risk Identification, Risk Analysis and Response Planning.
  • Connect concepts to lessons such as Qualitative Risk Analysis — What Is Qualitative Risk Analysis? — PMI-RMP Course.

Access: Free Video

Certificate: Free video viewing; Simplilearn certificate not included

Open the WikiFree course · Provider learning source

Learn, make, check

Keep a decision log as you work. For each stage, capture the assumption, your work product, a check and the change you made after that check. The acceptance criterion is the stopping condition for the stage.

Stage 1 / suggested project week 1

Describe uncertainty

Understand: A useful risk statement links cause, event and effect.

Make: Write six cause-event-effect risks and distinguish them from current issues.

Check before moving on: Avoid labels such as bad communication without a specific mechanism.

Study companion: Free Project Planning Course: Budgets and Risks. Use its relevant lessons and examples; the independent WikiFree task is not a provider assessment.

Save as evidence: a dated work product and a short note explaining one choice, one alternative and one remaining uncertainty.

Stage 2 / suggested project week 2

Assess consistently

Understand: Scores are a prioritization aid, not precise probabilities.

Make: Define likelihood and impact scales and apply them to the supplied cases.

Check before moving on: State assumptions and do not add ordinal scores as monetary losses.

Study companion: Free Simplilearn Course: Project Risk Management and Risk Analysis. Use its relevant lessons and examples; the independent WikiFree task is not a provider assessment.

Save as evidence: a dated work product and a short note explaining one choice, one alternative and one remaining uncertainty.

Stage 3 / suggested project week 3

Plan responses

Understand: A response needs an owner, trigger and resources.

Make: Choose avoidance, mitigation, transfer or acceptance actions for the top risks.

Check before moving on: Each action changes likelihood or impact in an explainable way.

Study companion: Free Project Management Course by Google. Use its relevant lessons and examples; the independent WikiFree task is not a provider assessment.

Save as evidence: a dated work product and a short note explaining one choice, one alternative and one remaining uncertainty.

Stage 4 / suggested project week 4

Monitor and escalate

Understand: Risk reviews ask whether assumptions have changed.

Make: Create a weekly review agenda and an escalation note for a triggered venue risk.

Check before moving on: Move a realized event into issue management while retaining the risk history.

Study companion: Free Project Management Course by Google. Use its relevant lessons and examples; the independent WikiFree task is not a provider assessment.

Save as evidence: a dated work product and a short note explaining one choice, one alternative and one remaining uncertainty.

Stage 5 / suggested project weeks 5–6

Present your portfolio

Assemble the four work products into Risk register, response plan and escalation briefing. Write a README explaining the problem, your assumptions, the decisions you made, tests actually performed and what remains incomplete.

Give a five-minute walkthrough: one minute for the problem, two for the work and evidence, one for trade-offs and one for the next improvement. If you have not implemented a proposed system, label it a design or prototype rather than a deployed solution.

Acceptance: a reviewer can locate each work product, reproduce the key reasoning and identify the limits without a private explanation from you.

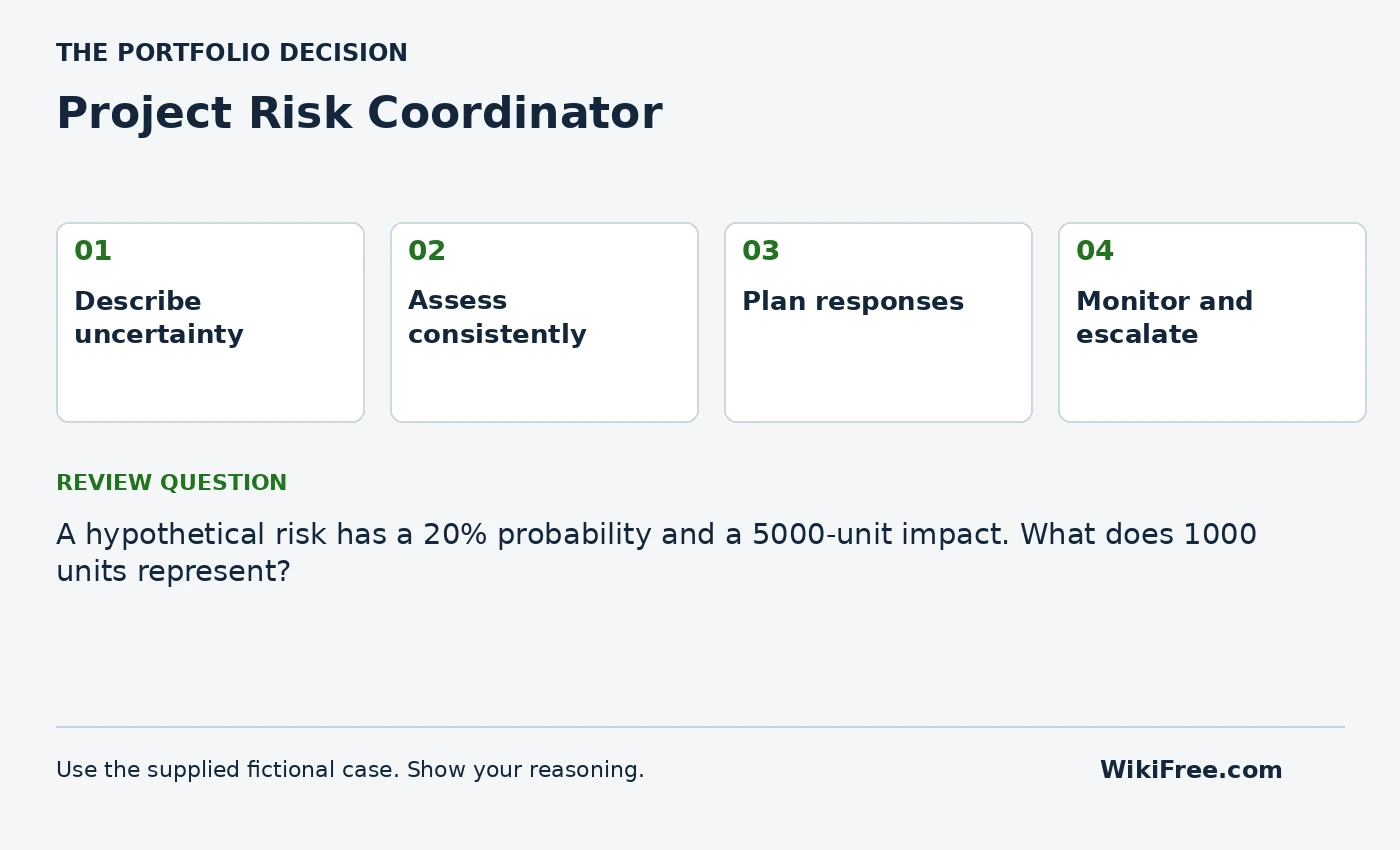

Project Risk Coordinator portfolio roadmap and a review question from the fictional case
The working roadmap for this case. The answer is explained in the self-check below.

The portfolio brief

A weekend learning event depends on a venue, a trainer and a registration system. Build a living risk register that connects early warning signs to decisions.

Deliver: Risk register, response plan and escalation briefing.

Fictional practice inputs
risk probability impact units owner
Venue unavailable 0.20 5000 Event lead
Trainer cancellation 0.10 3000 Learning lead
Registration outage 0.15 2000 IT lead

Use these small inputs to make the reasoning visible. They are not a representative dataset, a real client engagement or evidence of production performance. Where the brief requires additional sample records, create them yourself, label them synthetic and explain why you added them.

Download the portfolio kit

The ZIP includes the case CSV, four stage worksheets, course sequence, decision log, test log, portfolio README template, review rubric and reference reasoning. It is a starter kit for your work, not a completed application, professional report or proprietary project file.

Check your reasoning

A hypothetical risk has a 20% probability and a 5000-unit impact. What does 1000 units represent?

Write your answer and assumptions before opening the reference.

Read the reference reasoning

It is the expected monetary value under that probability-and-impact model, not a prediction that the project will lose 1000 and not a substitute for a response plan.

Portfolio review rubric

Criterion Points Evidence required
Problem and scope 4 A clear user, need, boundary and assumptions
Role-specific work 8 2 points for each of the four stage acceptance checks
Reasoning and validation 4 Independent checks, actual results and uncertainty
Communication and reproducibility 4 A usable README, source links and reviewable work products

Aim for at least 16/20 as a self-review target, with no missing stage acceptance check. This is a WikiFree practice rubric, not an industry credential or a hiring assessment.

Interview practice

Which trigger would cause you to escalate, and who makes the response decision?

Answer using the case: context, your action, evidence and limitation. Describe this honestly as a self-directed project. Do not present fictional organizations, invented interviews or practice results as paid work experience.

Your progress

Use this checklist as a personal study aid. Progress is stored in this browser when local storage is available; it is not an account record or a certificate.

0 of 5 milestones complete

The lessons and projects remain readable without JavaScript. Automatic progress saving requires JavaScript.

Questions before you start

Will this path qualify me for a job?

It helps you study relevant foundations and produce a work sample. Employers may require additional skills, qualifications and experience. Review actual role requirements before applying; no job or certification is guaranteed.

Are all tools and certificates free?

The linked learning routes were selected for free viewing or reading. Follow the separate access and certificate notes on each course. Paid tools and cloud deployment are optional; document a local design when implementation resources are unavailable.

Can I follow this on a phone?

You can read the path and many learning resources on a phone. Coding, detailed spreadsheet work, design tools and mobile-app development are easier or require a suitable computer. The page is designed to reflow; that is not a claim that every physical device has been tested.

Created by WikiFree.com. Course references were selected from the published catalog snapshot checked on 13 October 2026. Access can change; consult each current course page. The case, exercises and rubric are original WikiFree learning materials.

Share this article

Questions & discussion

Share a useful question or correction. Comments appear after moderation. Please avoid personal or sensitive information.
